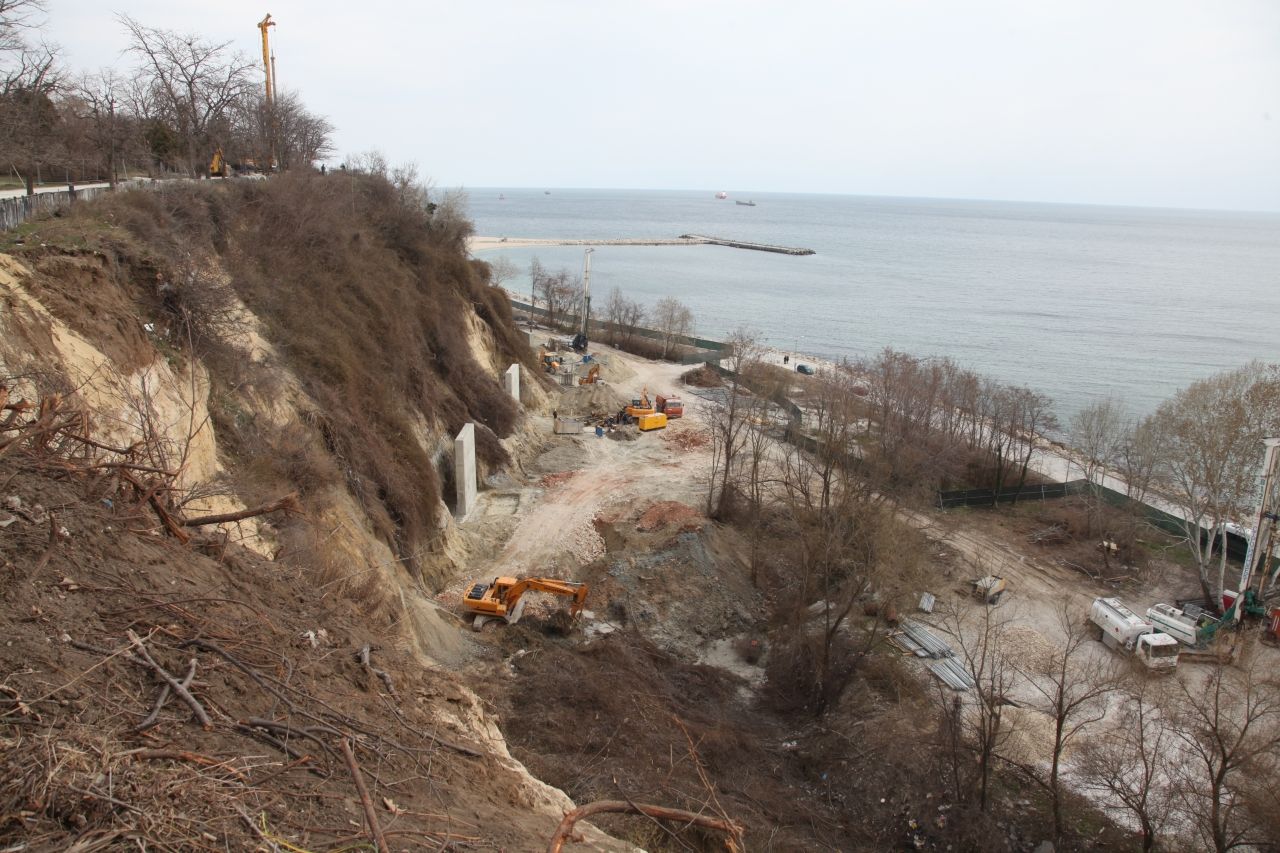

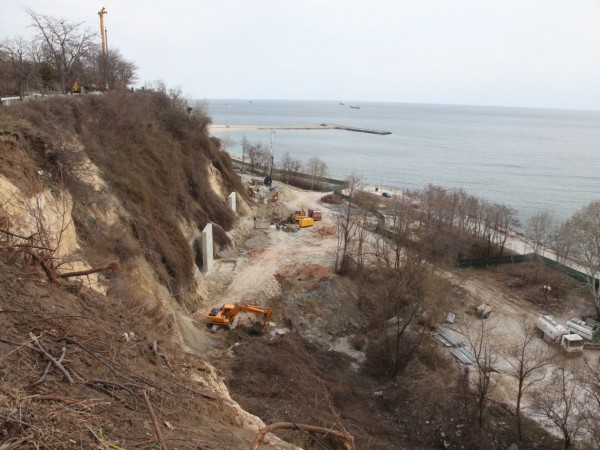

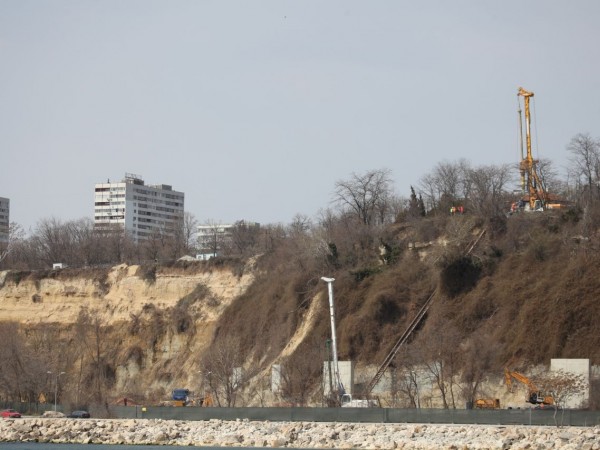

Anti-erosion reinforcement of Alley One, Varna city
Main activities for the project realization:

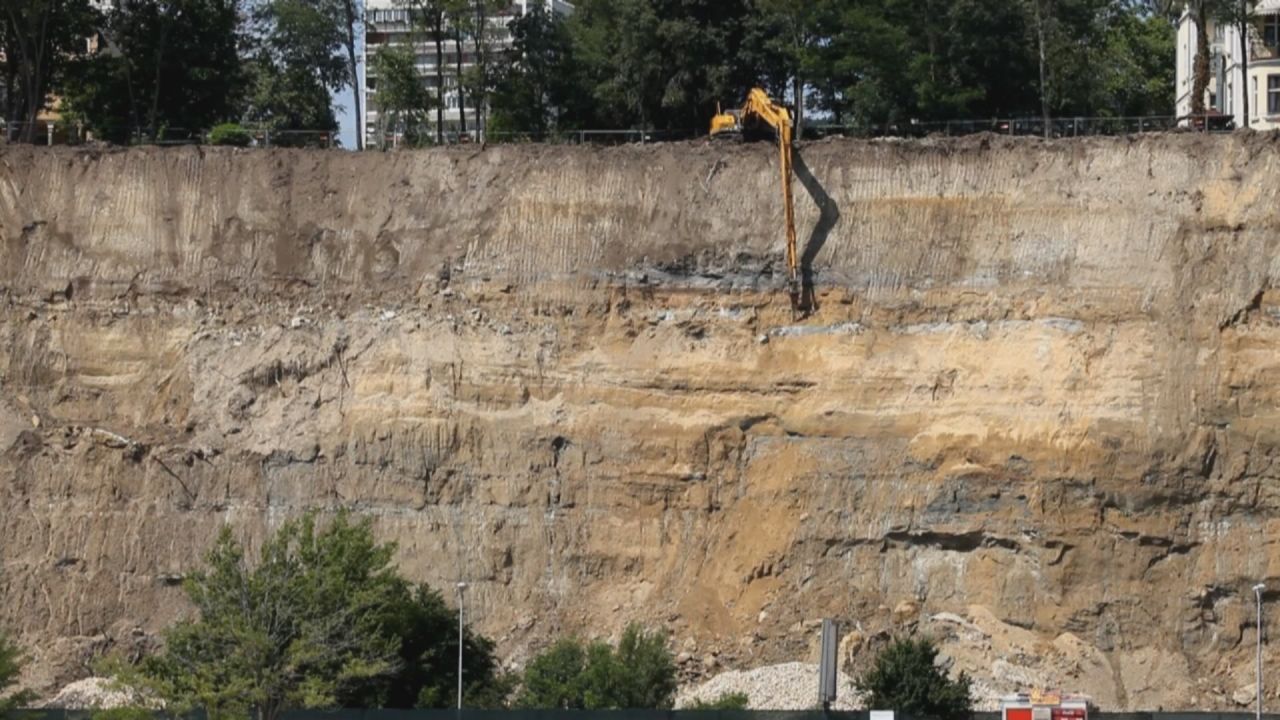

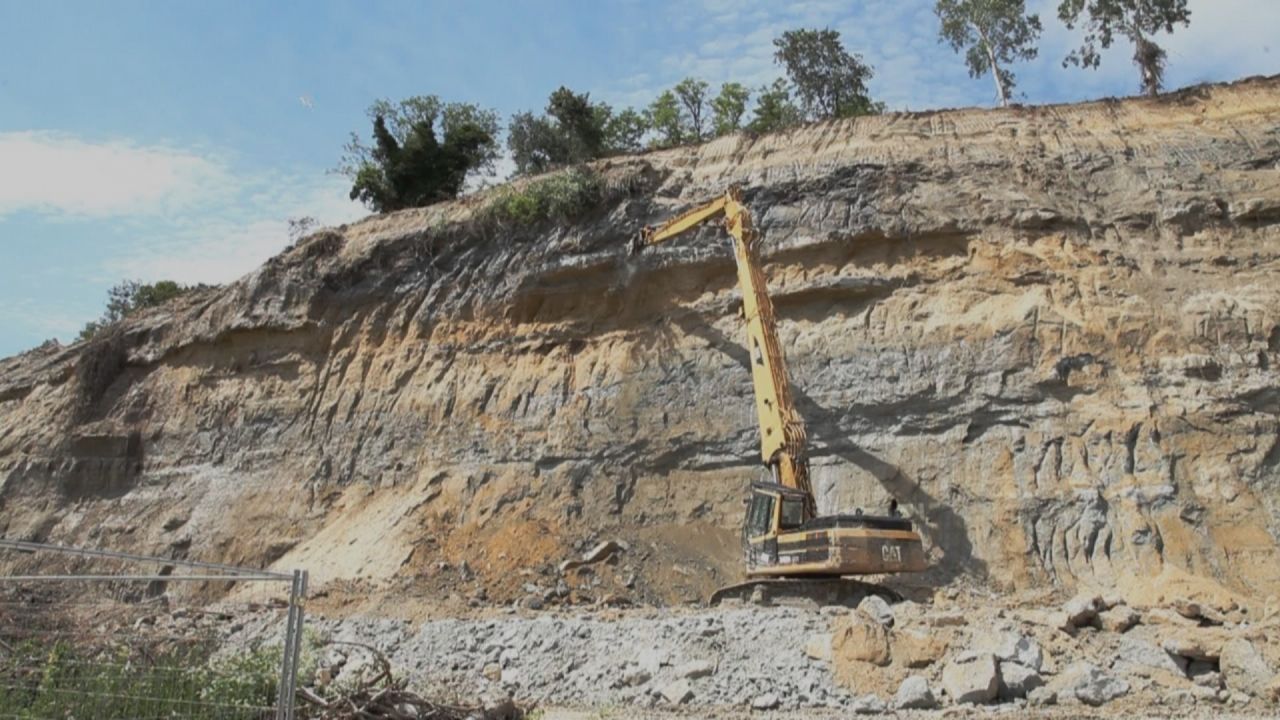

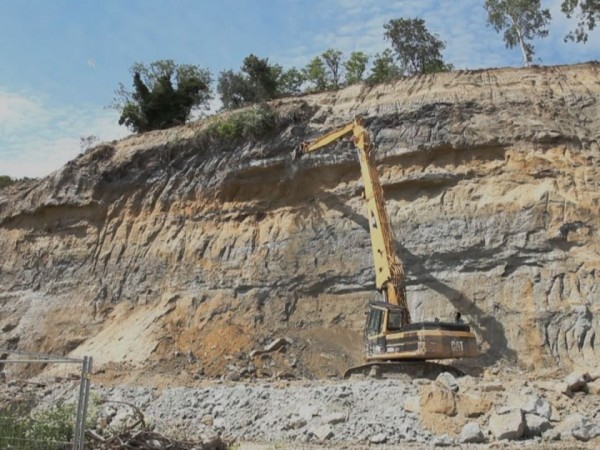

- Terrain and slope clearing and preparation – linear length of the construction site – 1070 meters.

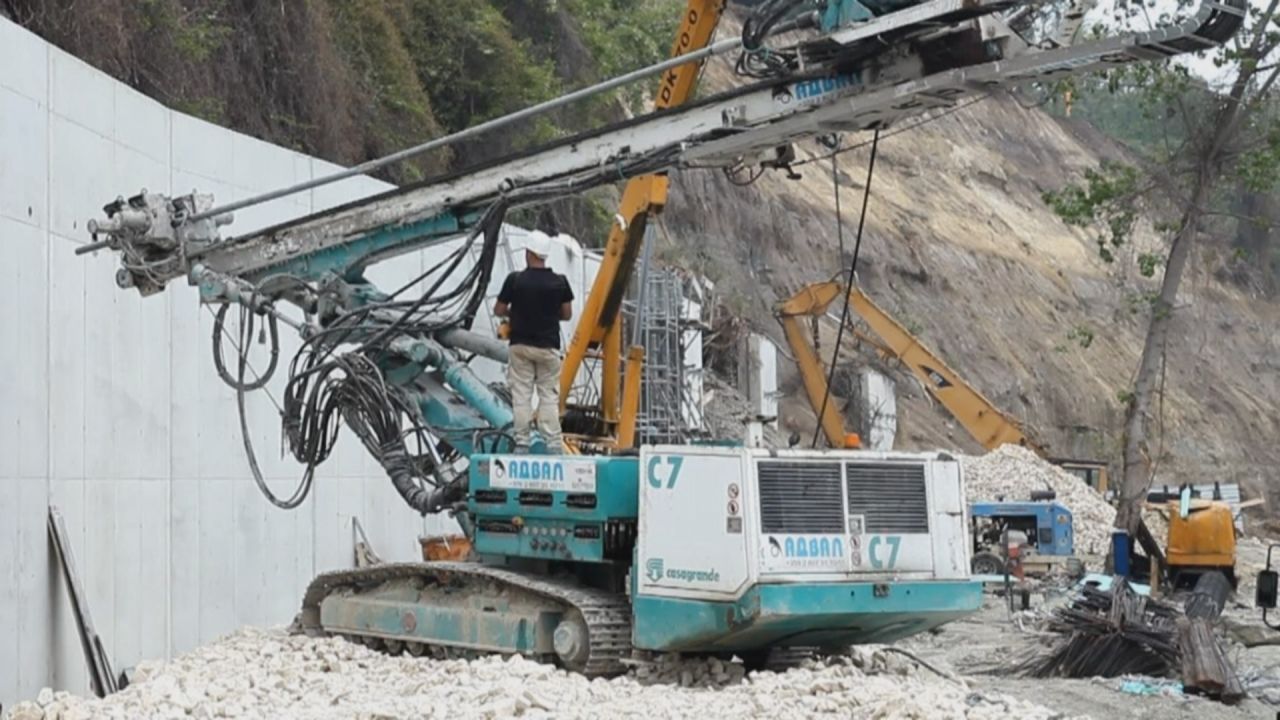

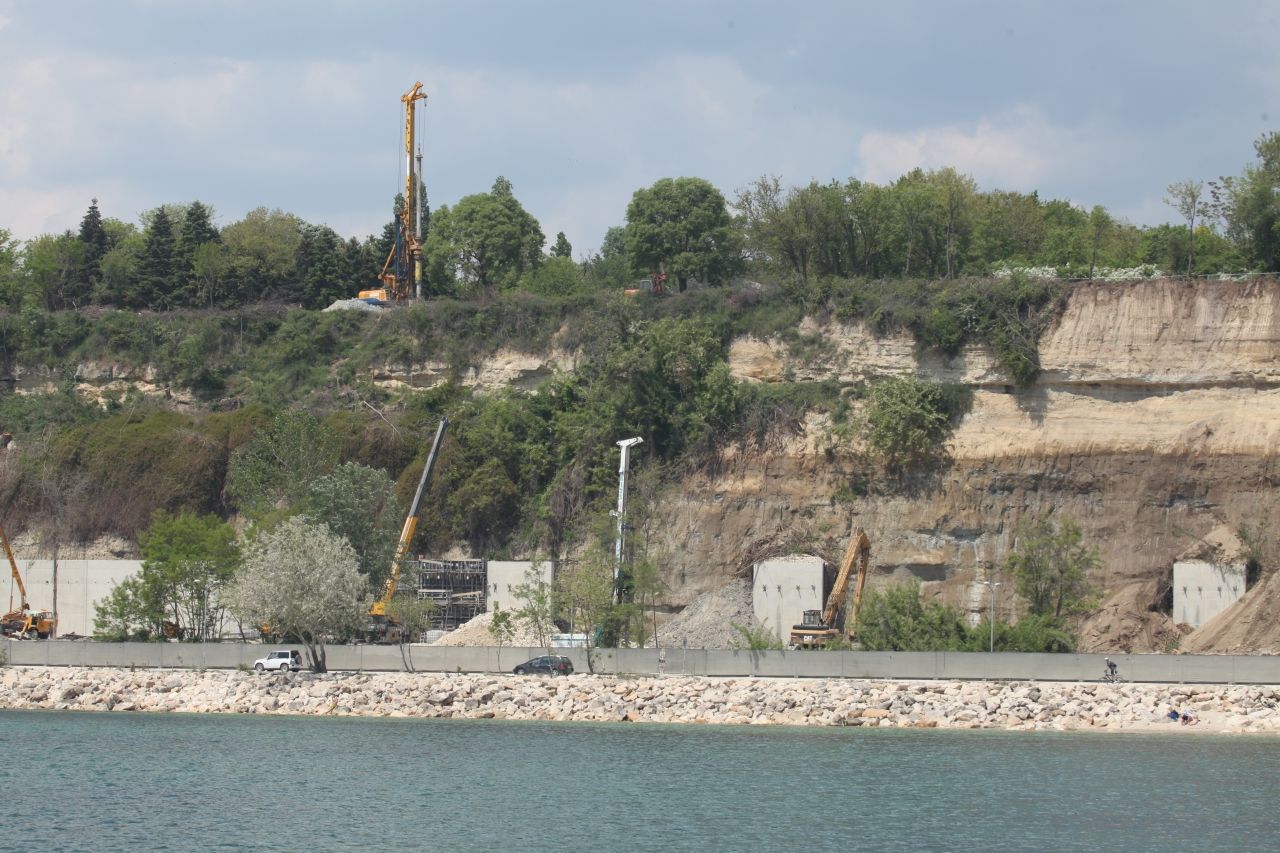

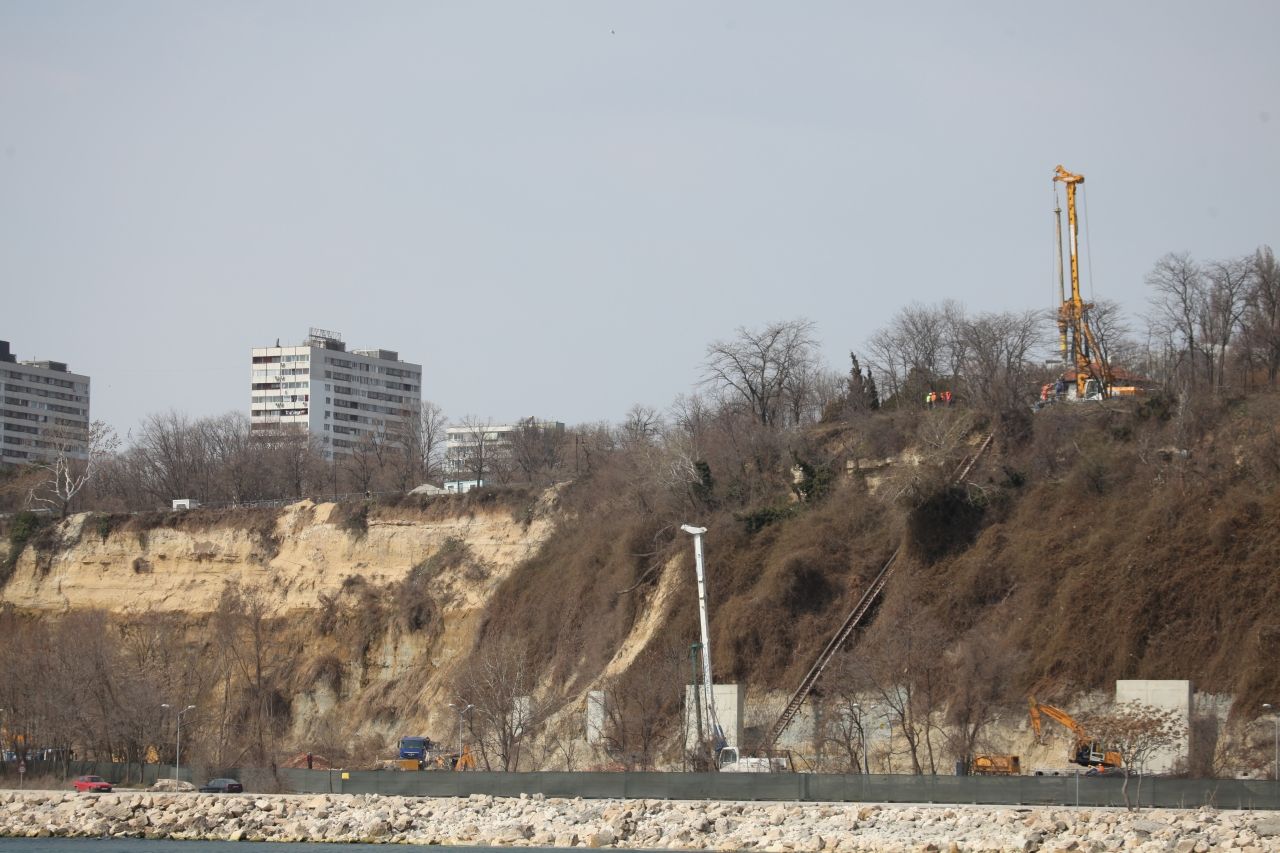

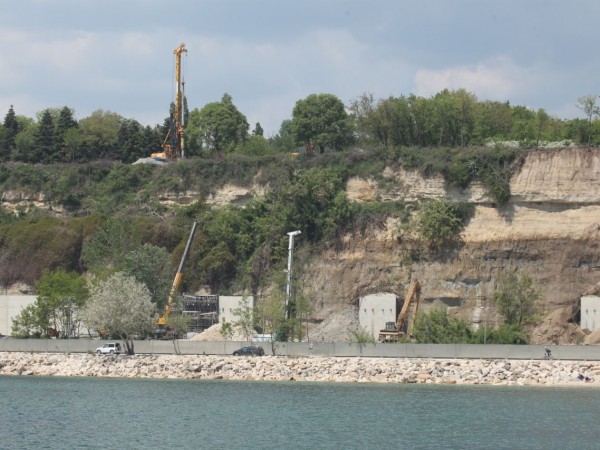

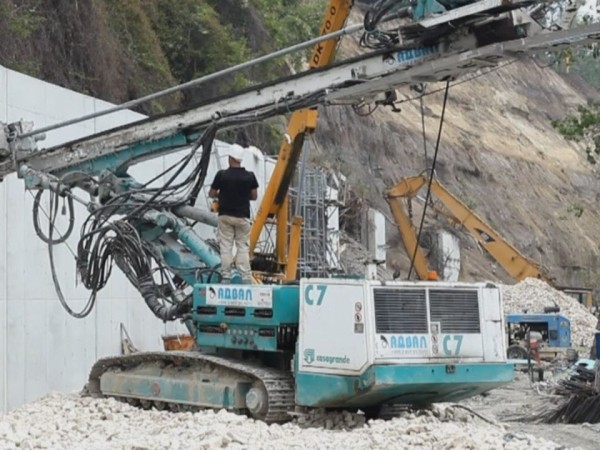

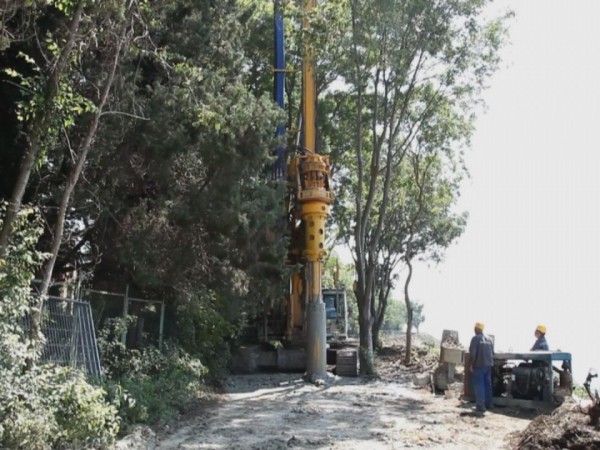

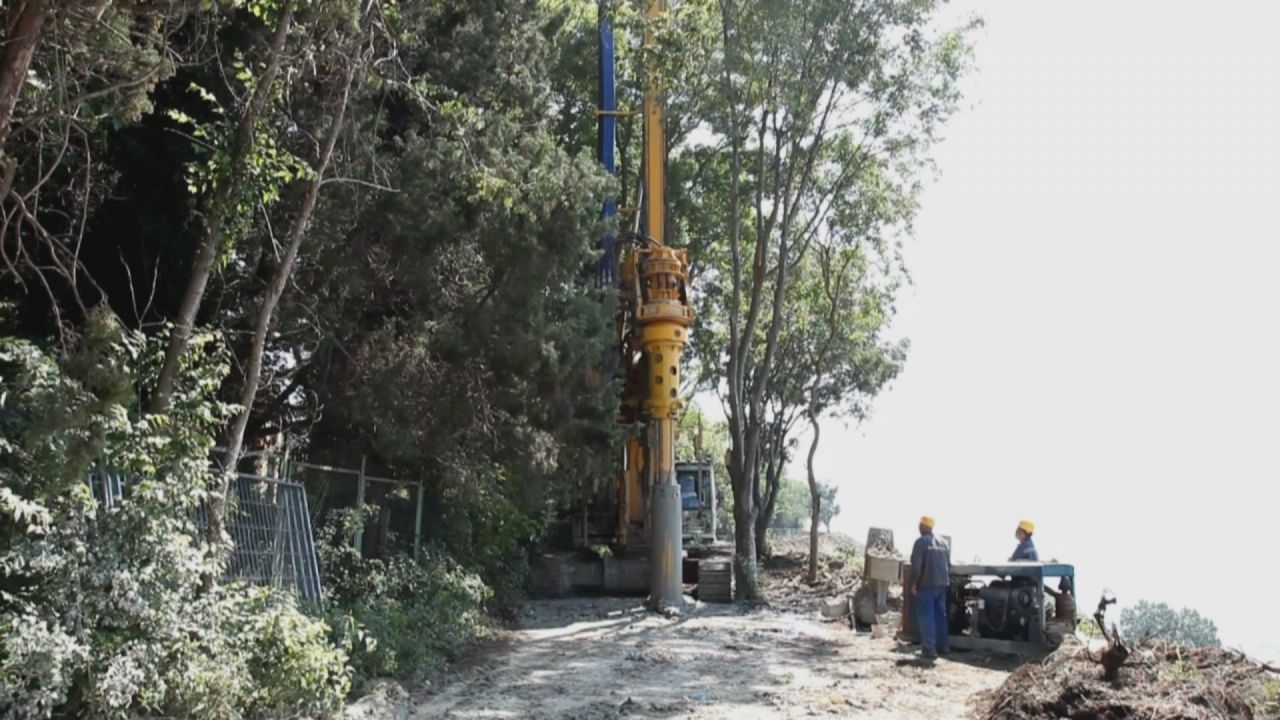

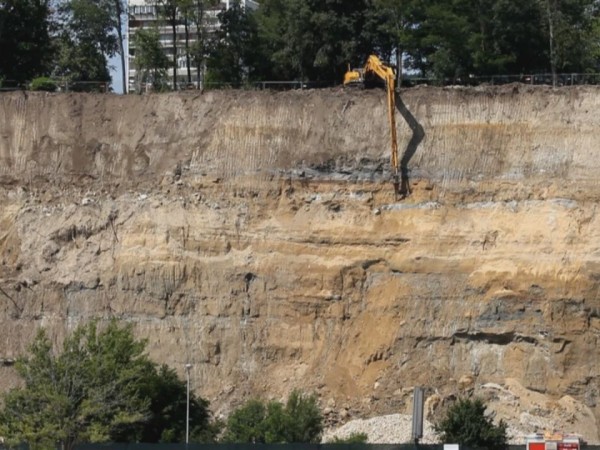

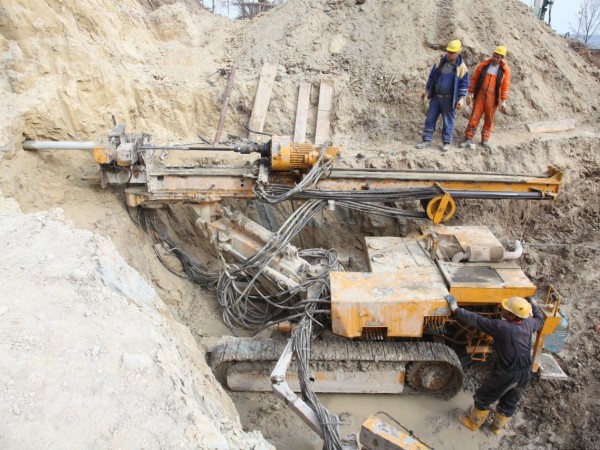

- Vertical drainage wells – drilling depth – 32 to 35 meters, diameter 600 mm. – 70 psc.

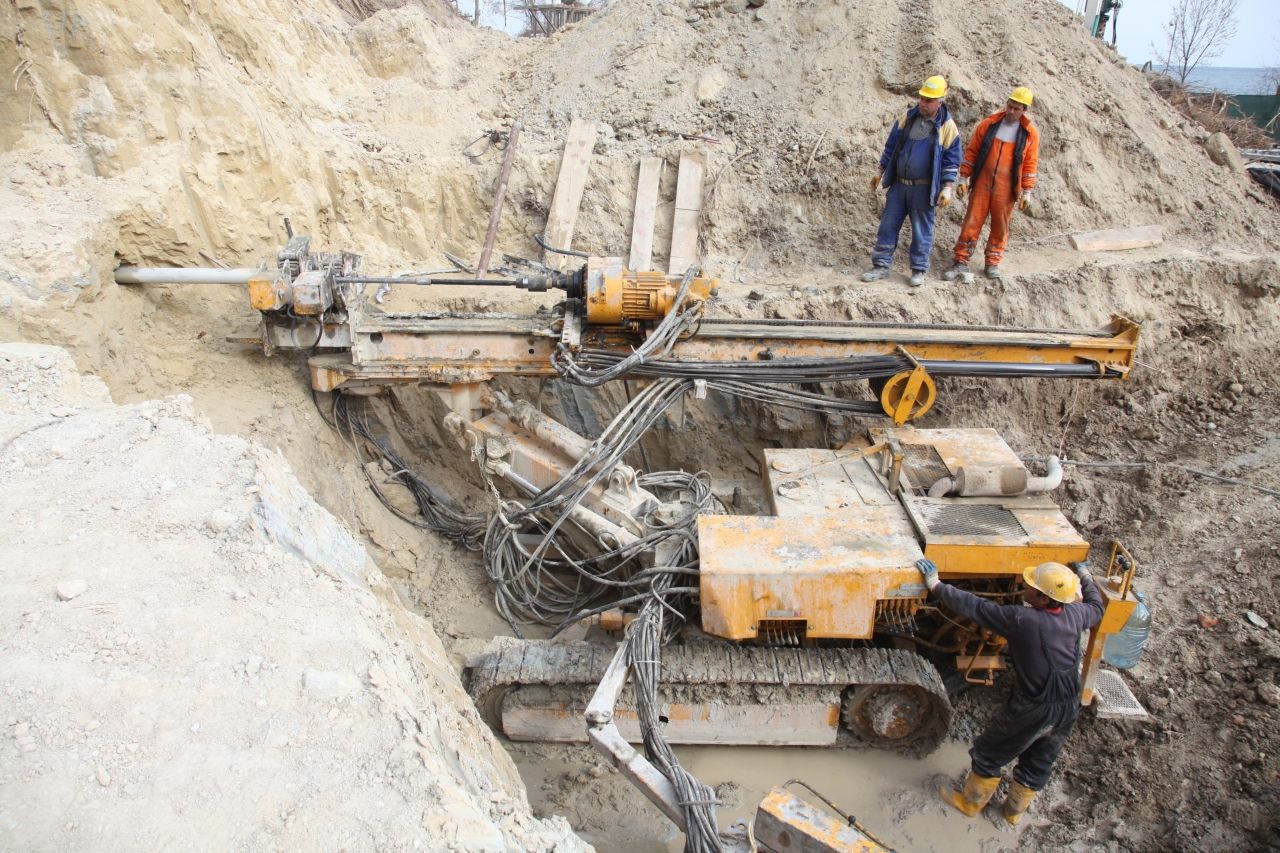

- Horizontal drilled drainages – length from 24 to 30 meters - 70 psc.

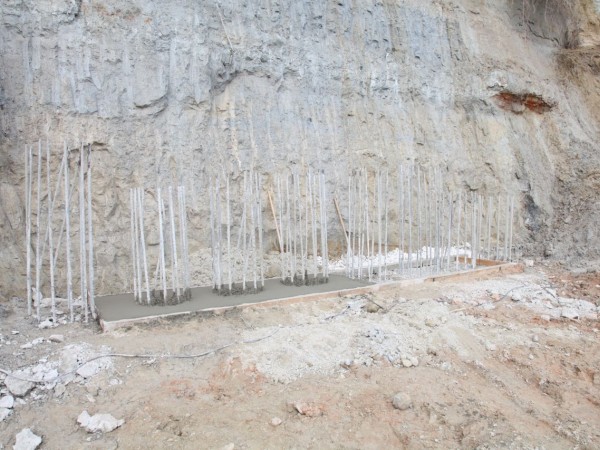

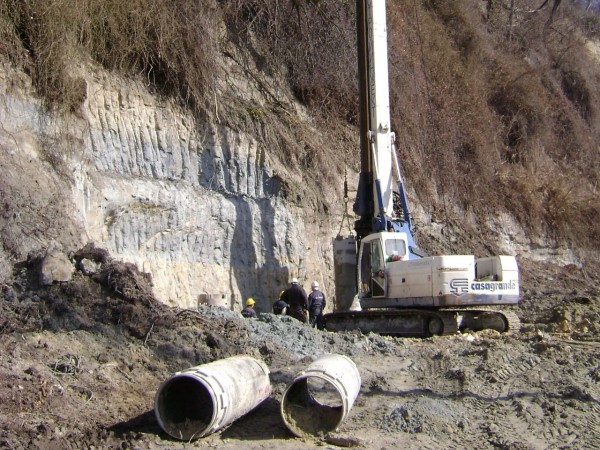

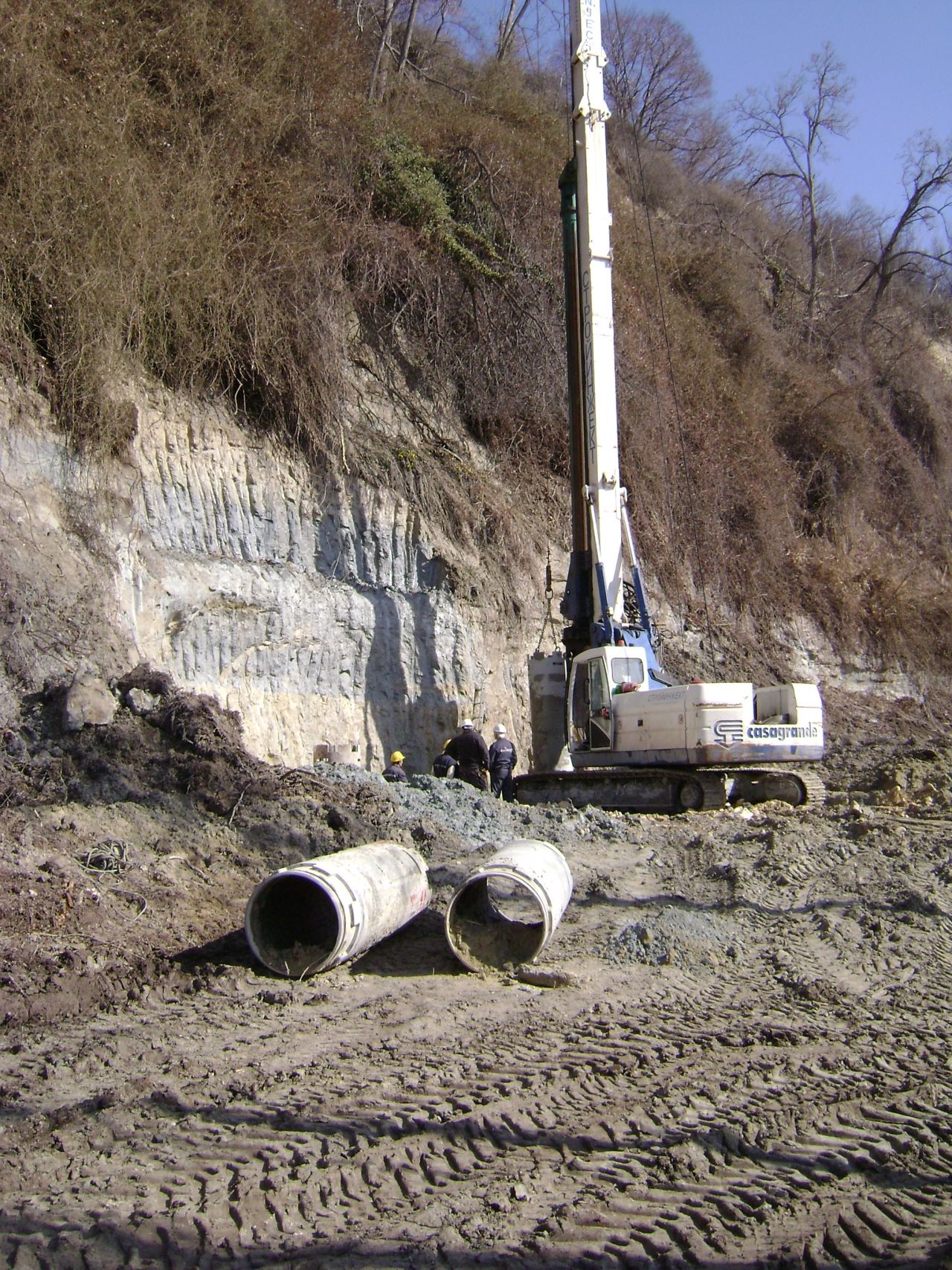

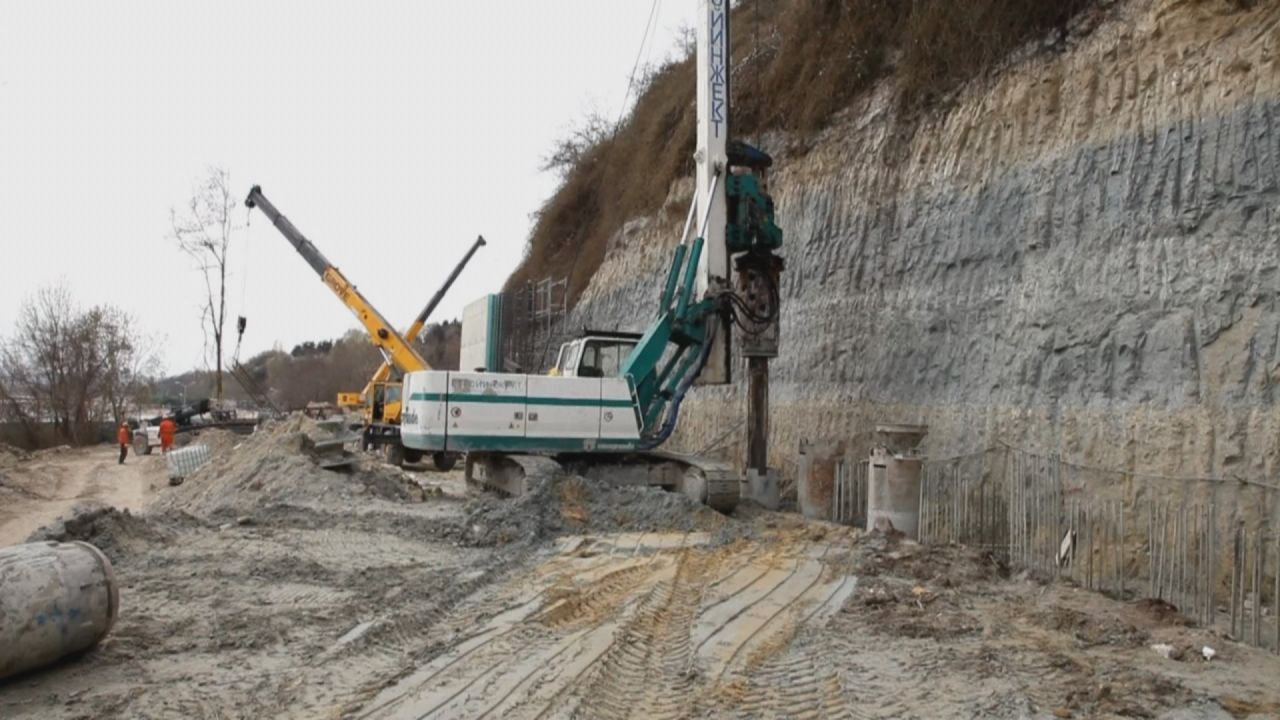

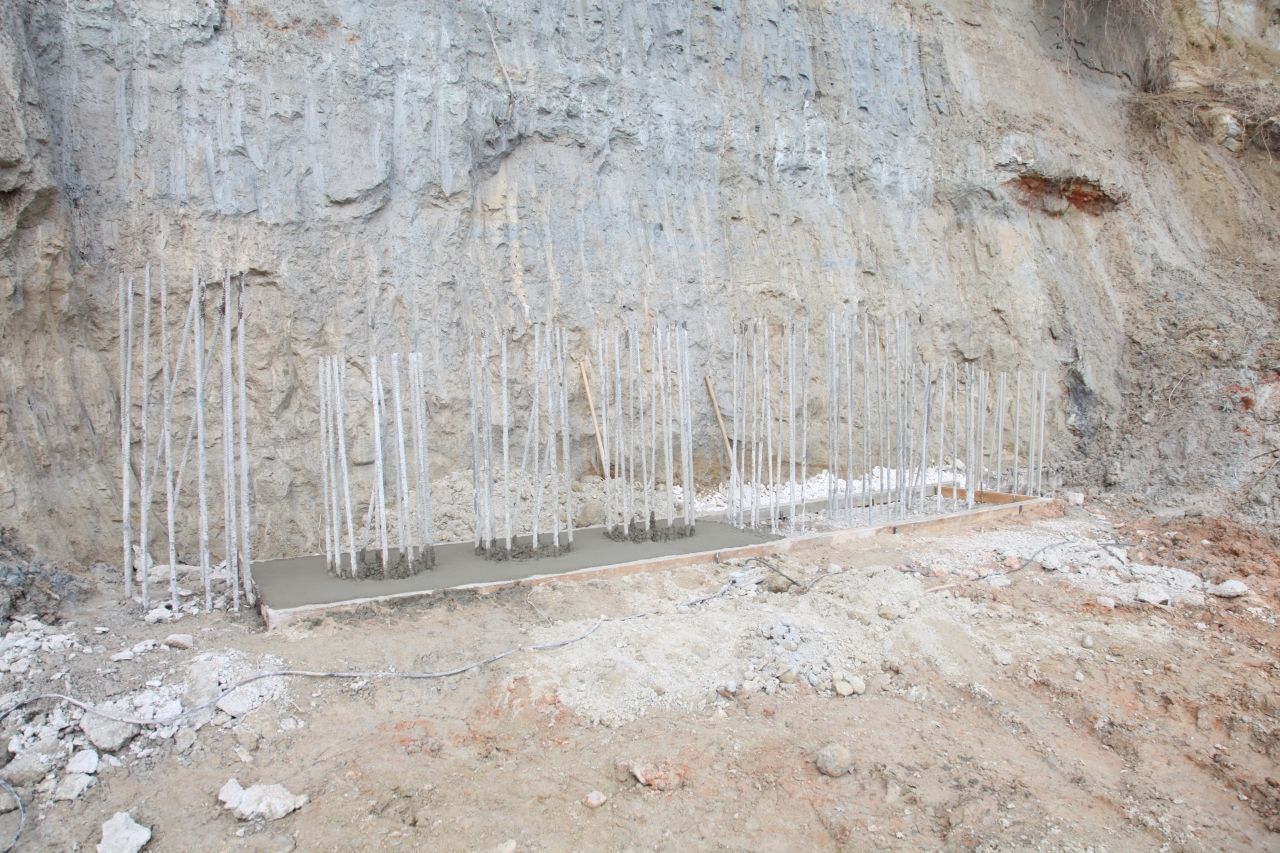

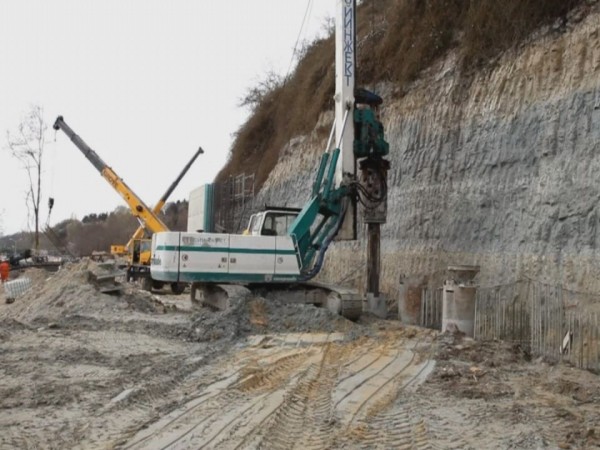

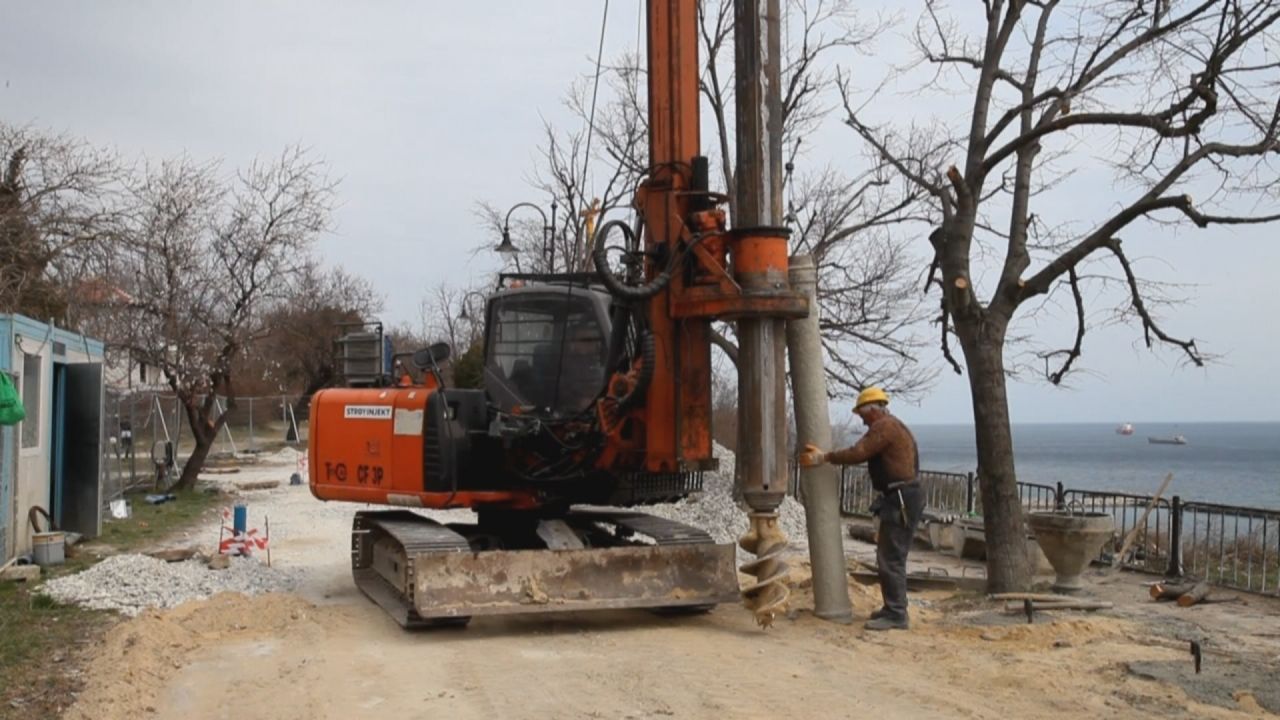

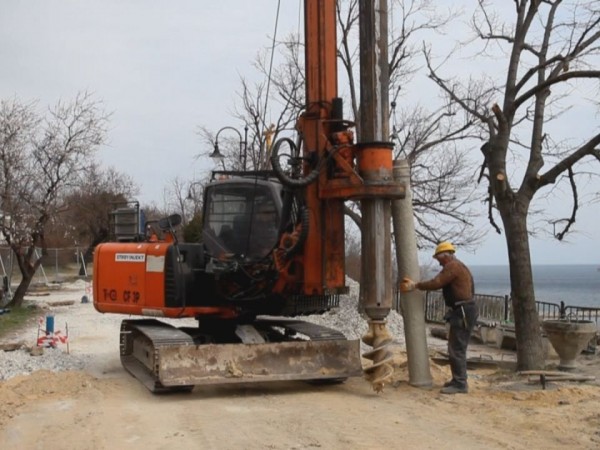

- Steel reinforced pile constructions placed in the base of the slope- diameter 800 mm, length 7,50 meters – 1070 pcs.

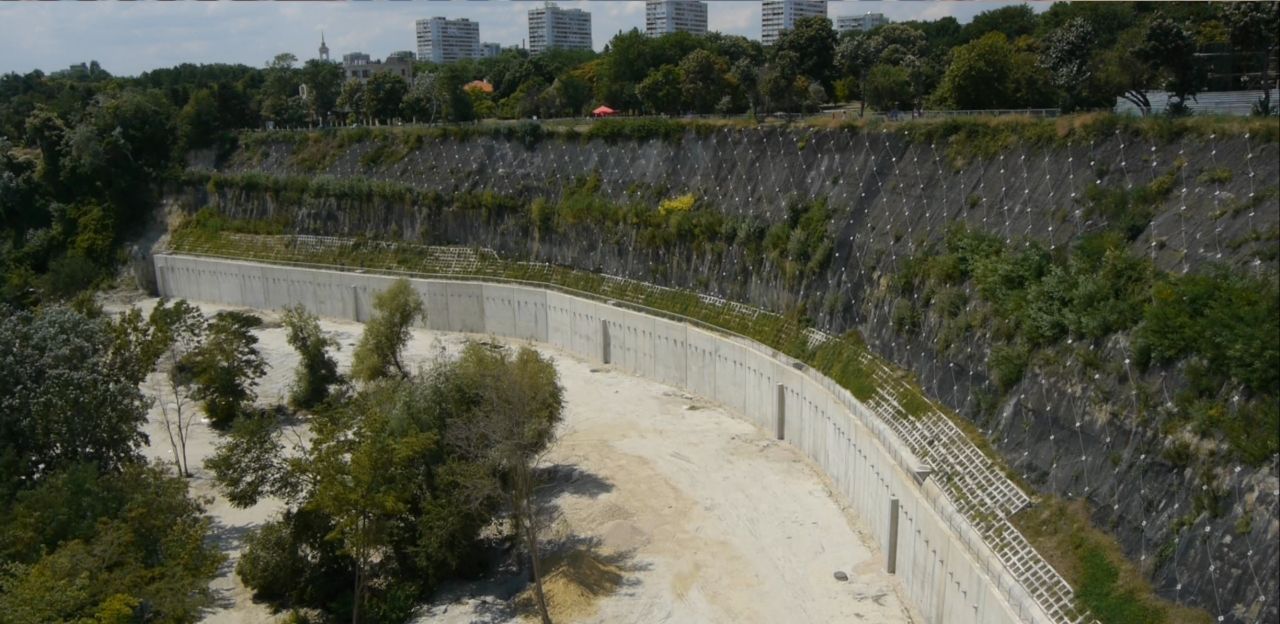

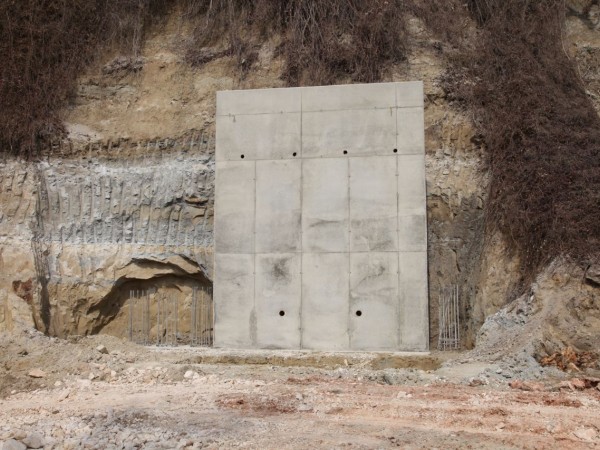

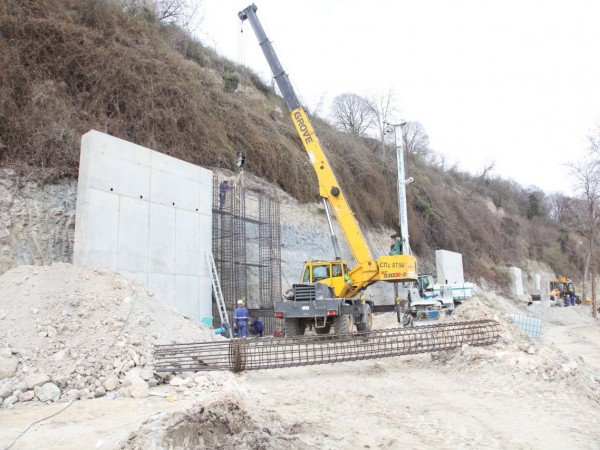

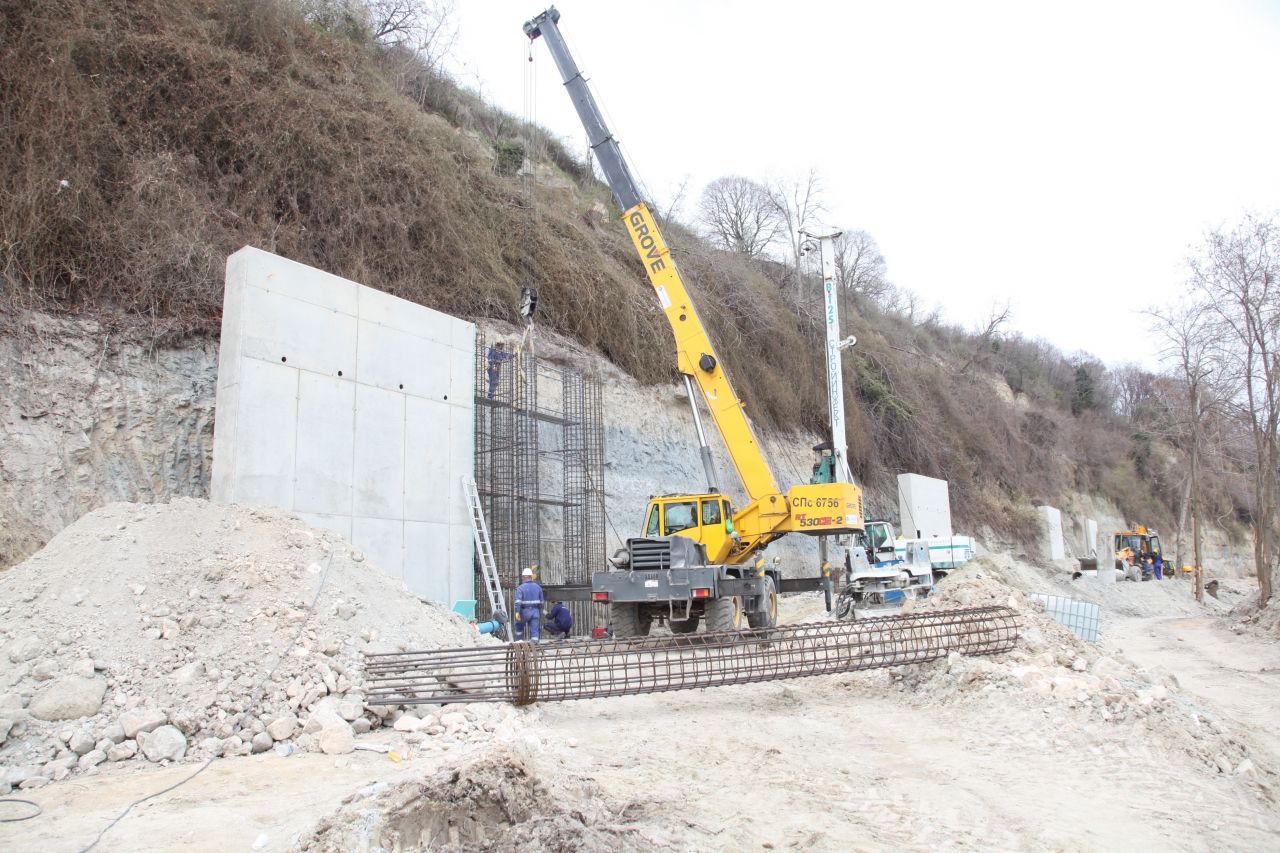

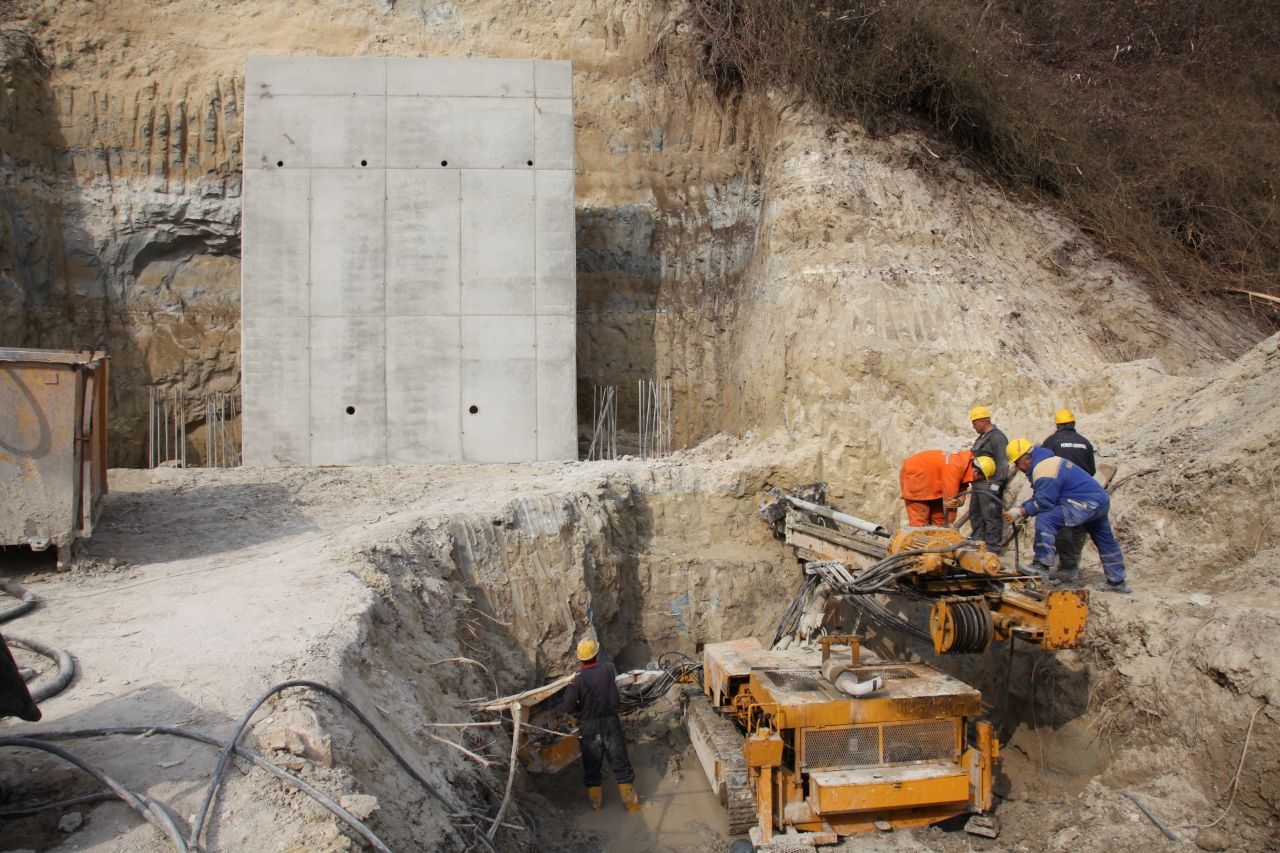

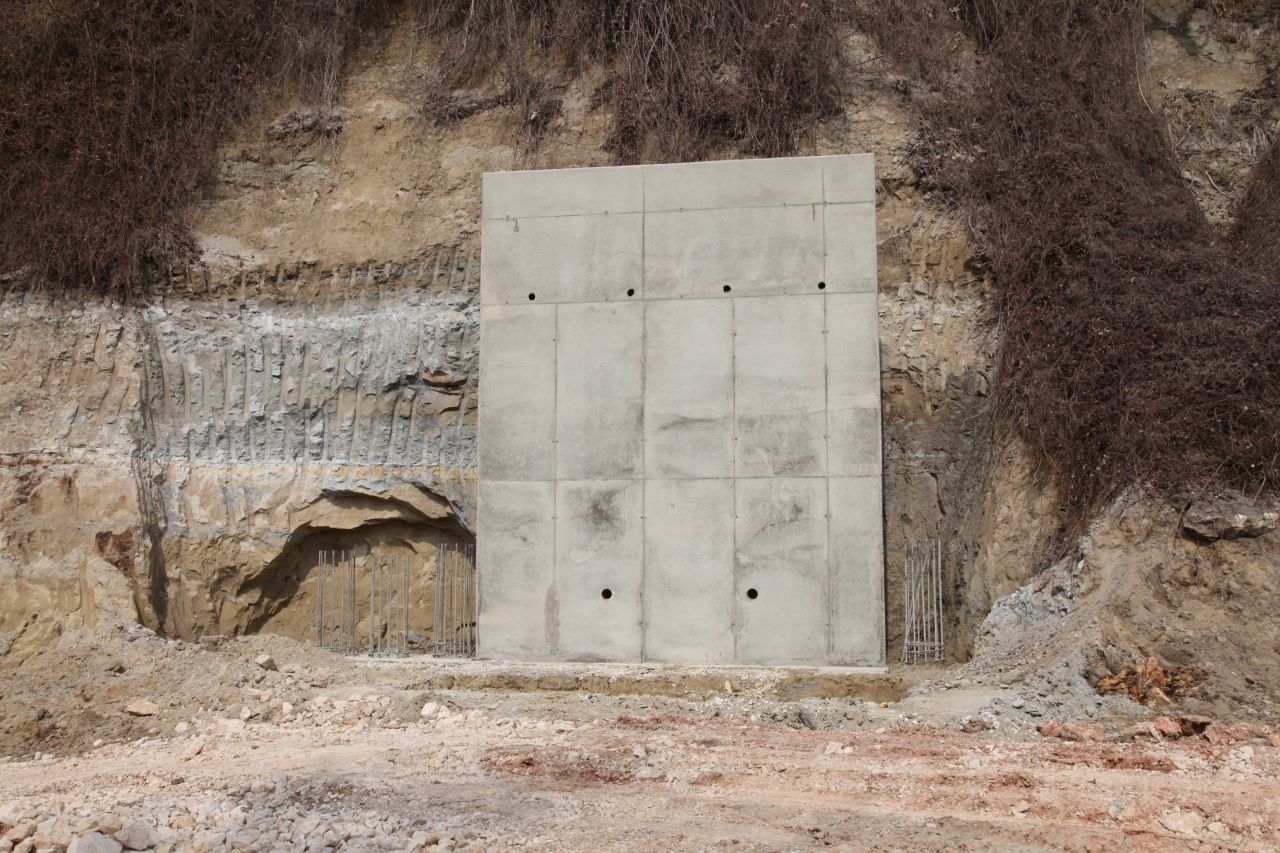

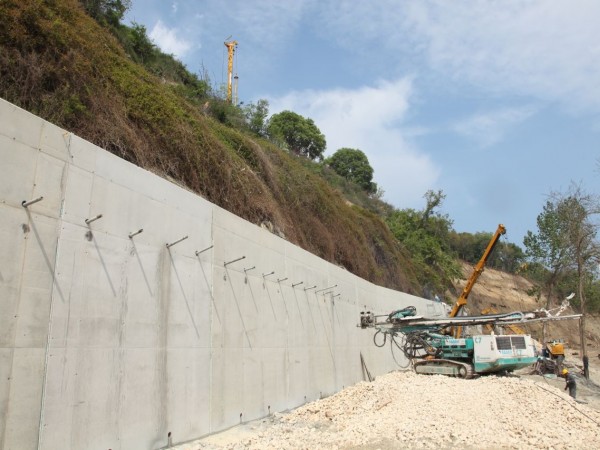

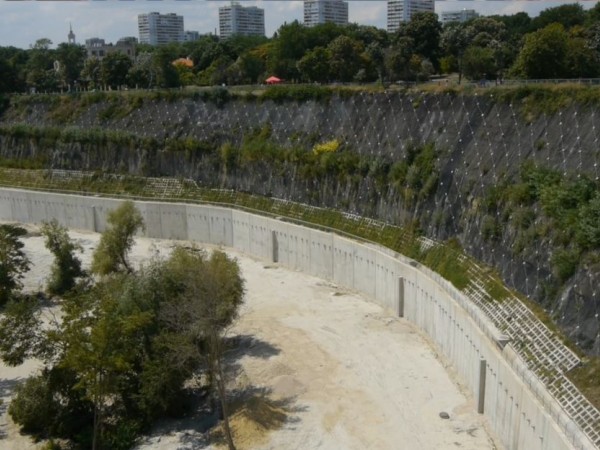

- Supporting steel reinforced walls – height 7,50 m., length 6 m. Width 0,8 meters – total length – 1070 meters.

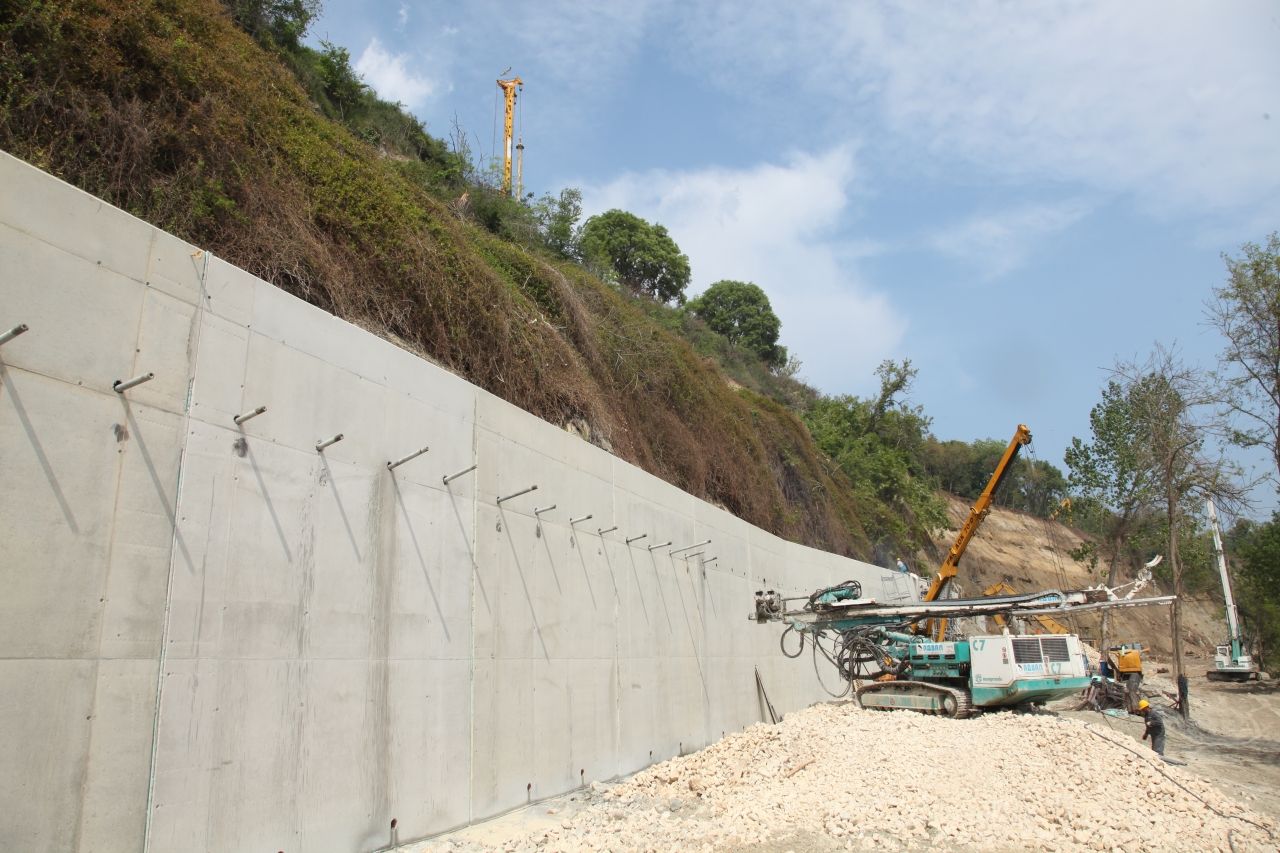

- IBO anchor constructions Т76 with length of 23 meters passing through the supporting walls - 722 psc. х 23 m = 16 606 meters
- Steel reinforced pile constructions placed on the top of the slope – diameter of 350 and 600 mm
- Piles ∅ 350 mm. L = 5,00 m. - 385 pcs.
- Piles ∅ 600 mm, L = 8,00 m. – 134 psc.

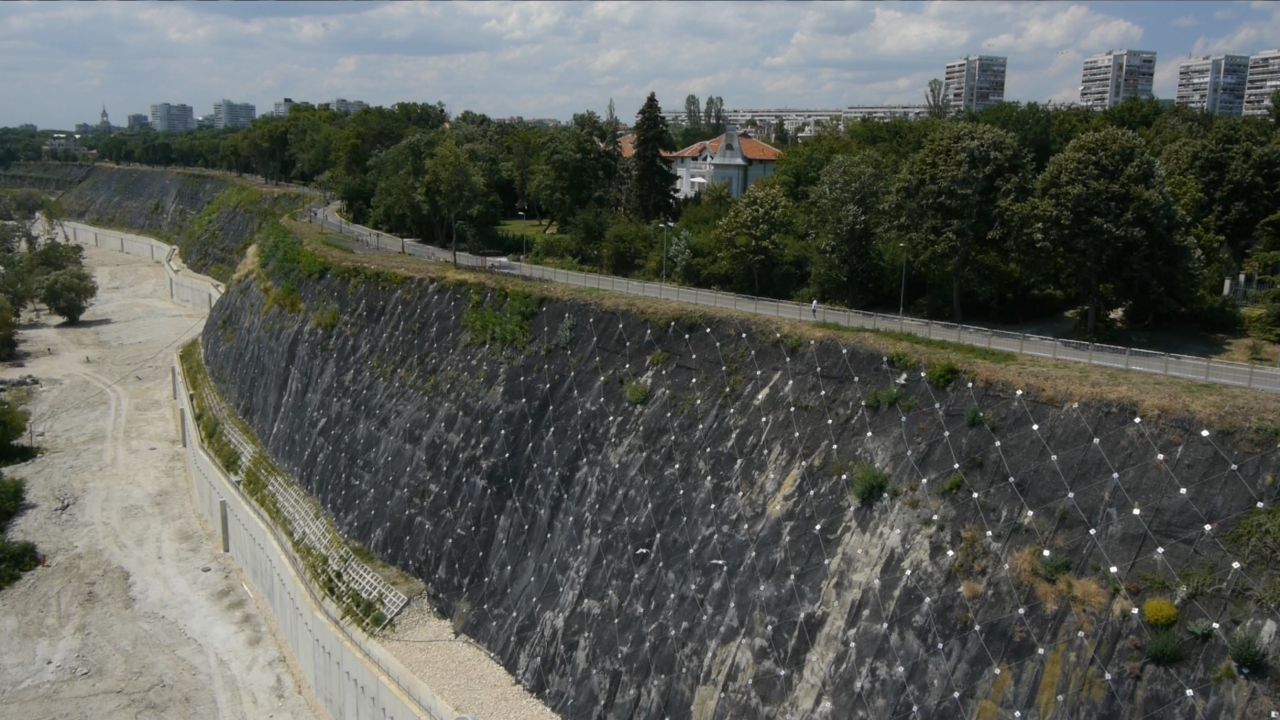

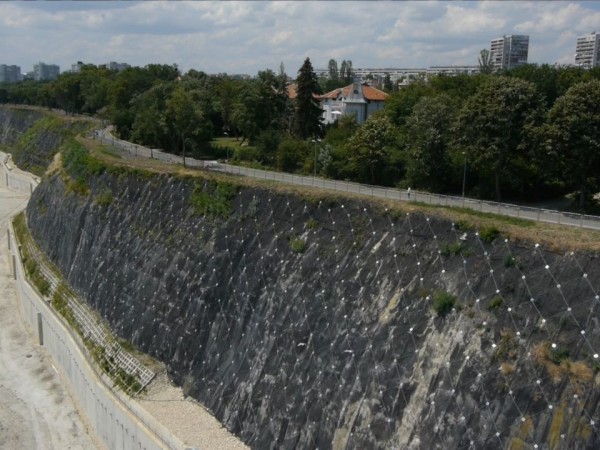

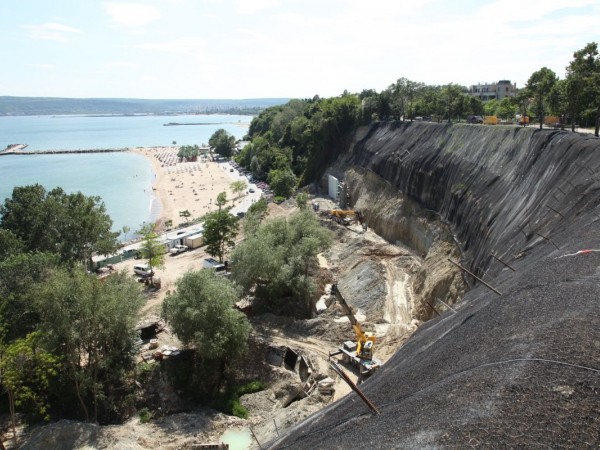

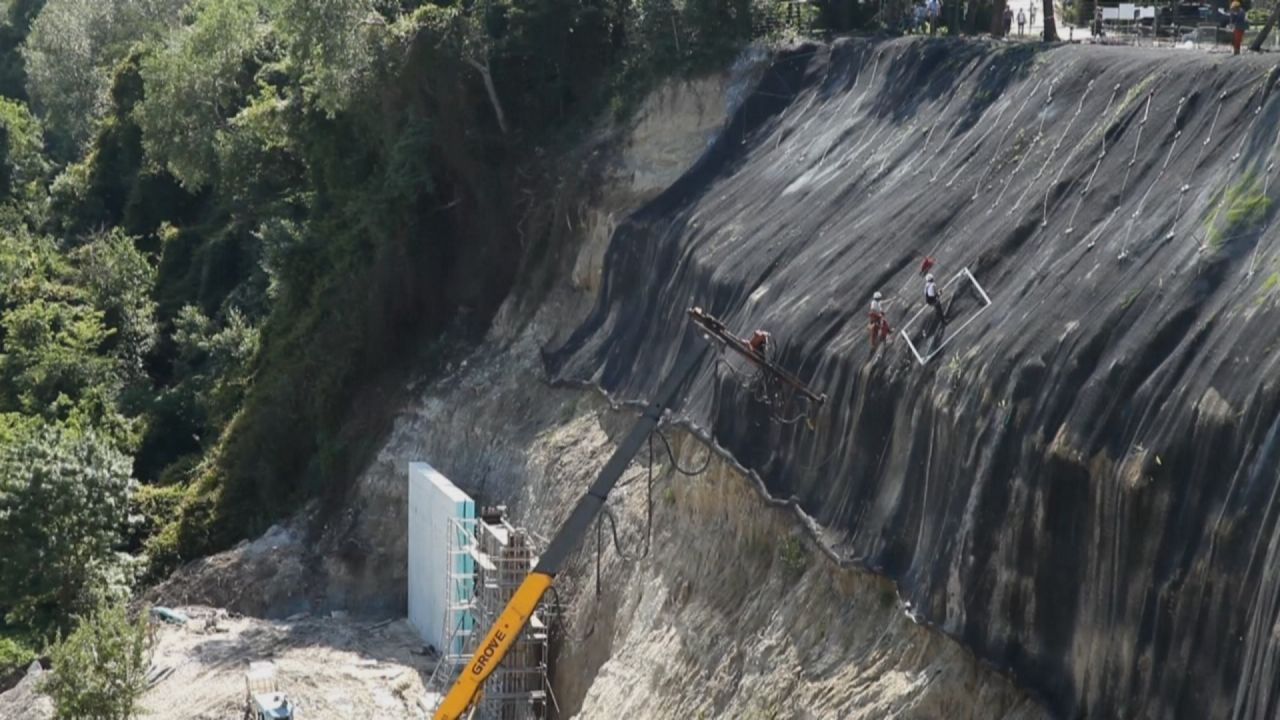

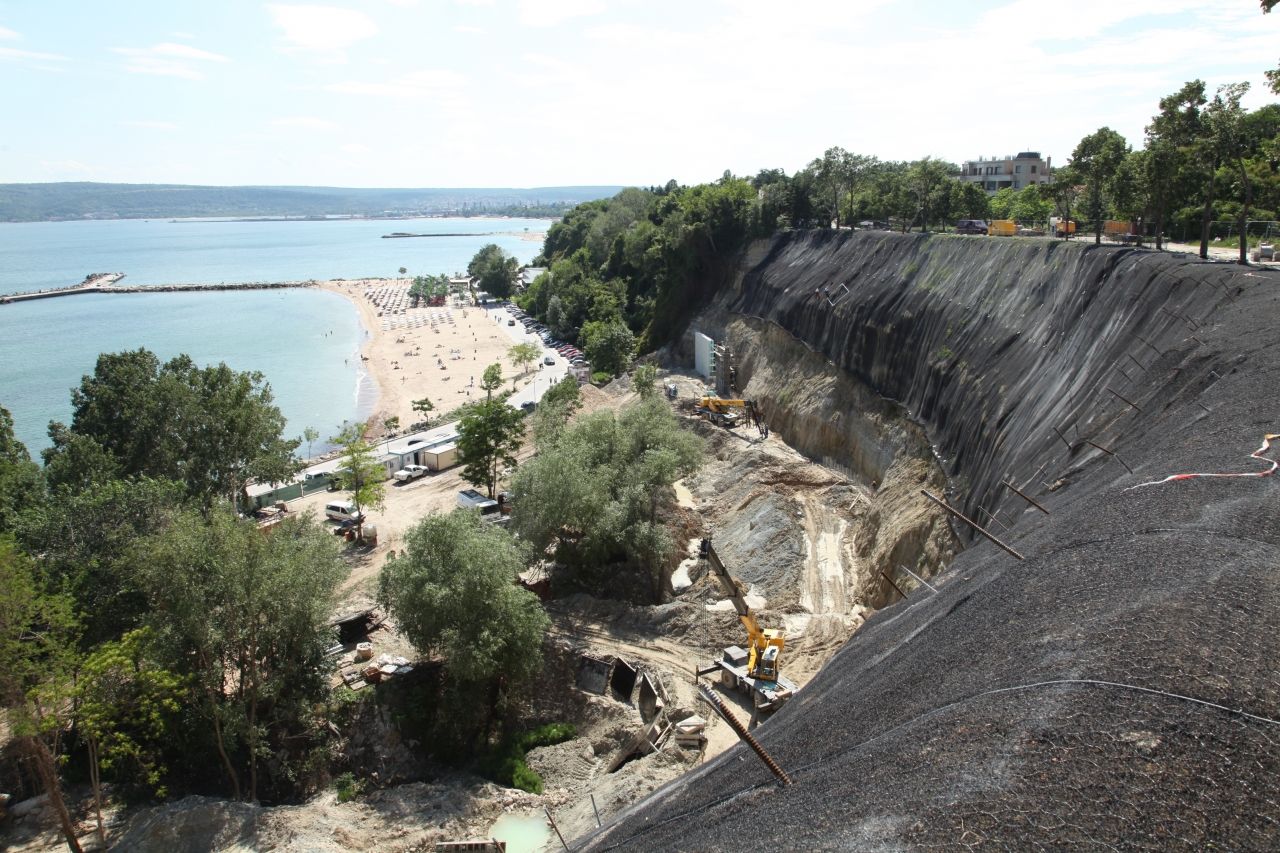

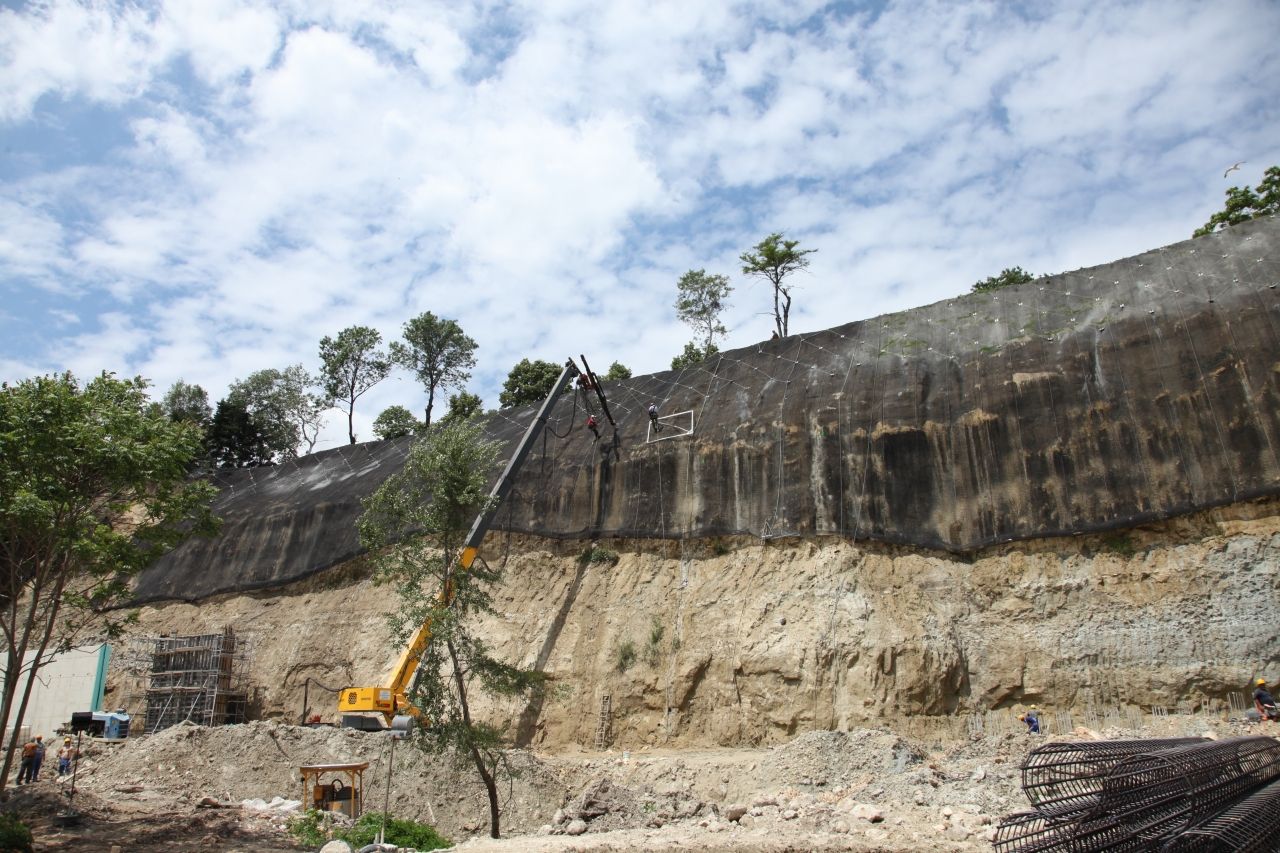

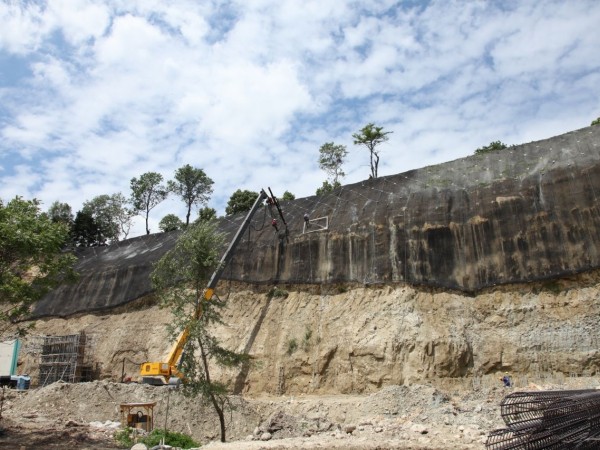

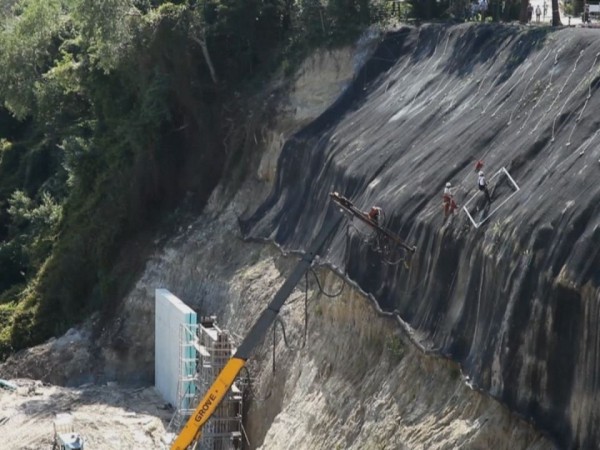

Placing and anchoring of double twisted net on the slope – 28 150 sq.m.
Anchors for fixation of the net and fortification of the slope
- R32N x 6 m – 1900 psc.
- R25N x 4 m – 2450 psc.
- R25N x 6 m – 100 psc.

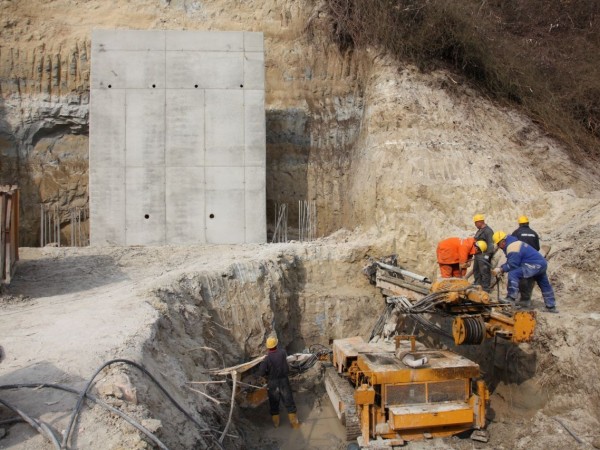

Steel reinforced concrete cages 180/180 cm. – 900 psc.
Anchors for fixation of the Steel reinforced concrete cages to the slope
- R32N x 6 m – 980 psc.
- R25N x 6 m – 2500 psc.
